Why Purchase Approvals Take Days (and 7 Ways to Fix It)

Suppliers quote in hours, yet internal sign-off takes days. Most of that time is waiting, not work. Here is how to find it and cut it.

Glass-style illustration of an in-tray of requests feeding a large clock, then a checklist, an approval checkmark and finally a shopping trolley of boxes, linked by one glowing path.
In this article
  1. Why it takes days when the supplier replied in hours
  2. Waiting time vs work time
  3. The five usual causes
  4. 1. Nobody is sure who approves
  5. 2. The request is incomplete
  6. 3. Nobody follows up
  7. 4. The approver is away and there is no backup
  8. 5. Approvals are buried in chat and email
  9. Seven fixes, and who does each one
  10. How to measure before and after
  11. Diagnostic table: symptom, likely cause, fix
  12. How RequisitionPro helps
  13. Related questions
  14. Next step

Quick answer: Purchase approvals take days because a request spends most of its life waiting: for the right approver to notice it, for missing details, or for someone to come back from leave. The reading and deciding usually takes minutes. To fix purchase approval delays, name one approver per step, refuse incomplete requests, set a response target, plan backups for absences, keep approvals in one place and measure how long each step really waits.

Why it takes days when the supplier replied in hours

A supplier answers quickly because quoting is their job and your order is their income. Inside your business, approving the purchase is nobody's main job. It competes with meetings, month-end work and travel, so it sits in a queue.

The cost is real. A quote with a short validity period can expire while it waits, so you go back to the supplier and the price has moved. Stock runs out. Staff who are tired of waiting start buying around the process, paying from their own pocket or splitting purchases into smaller amounts (we cover that in how to stop purchase splitting). And a reviewer later finds approvals given after the goods had already arrived.

Delay at the approval desk is a recognised problem in Nigerian public procurement too. In March 2026 the News Agency of Nigeria reported the Director-General of the Bureau of Public Procurement telling a training for public officials in Abuja: "If a file stays on your table for 48 hours, you are already violating guidelines." That remark was about government procurement, not private businesses, but the point carries over: a file that nobody is working on is a cost.

Waiting time vs work time

The useful question is not "how long did approval take?" but "how much of that time was anyone working on it?" Lean practitioners separate the two. The Lean Enterprise Institute defines processing time as the time an order is actually being processed, and production lead time as the whole time it takes to move through a process from start to finish. It notes that processing time is typically a small fraction of lead time. Purchase approvals follow the same pattern.

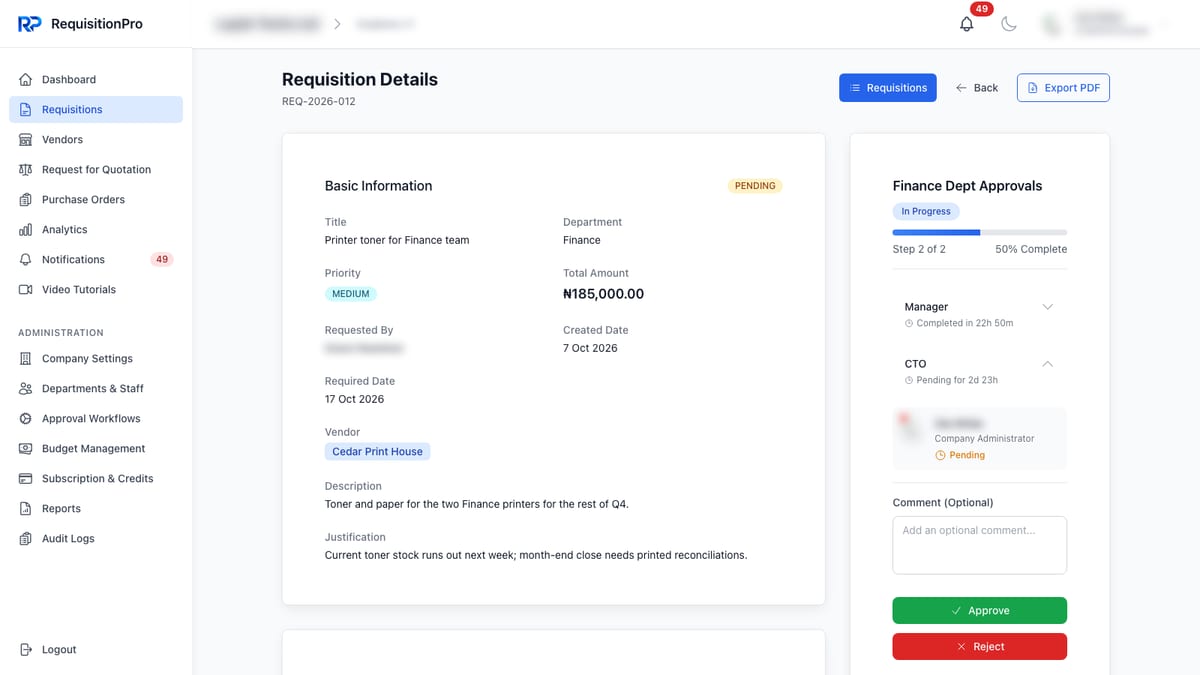

Take the request in the screenshot below (demo data, illustrative). A ₦185,000 toner request has two approval steps. The manager's step took 22 hours 50 minutes; the second step has been pending for 2 days 23 hours. If each approver needs ten minutes to read the request and decide, about 20 minutes of work has taken close to four days. Cutting the 20 minutes will not help. Cutting the waiting will.

RequisitionPro requisition details for a pending ₦185,000 printer toner request, with a two-step Finance Dept approval panel showing the Manager step completed in 22h 50m, the CTO step pending for 2d 23h, an optional comment box, and Approve and Reject buttons

The five usual causes

1. Nobody is sure who approves

The request goes to whoever the requester thinks is right, who forwards it or assumes someone else will act. Each hand-off can add a day.

2. The request is incomplete

The approver opens it, finds no quote, no budget line or no reason, asks a question in a message, and moves on. The request then waits twice: once for the answer, once for the approver to come back to it.

3. Nobody follows up

Without a reminder, a pending request depends on the approver's memory, and requesters may not know it is stuck or may feel awkward chasing a senior colleague.

4. The approver is away and there is no backup

Leave, travel or illness stops everything behind that one person. US federal internal control standards (the GAO's Green Book) expect management to define contingency plans for assigning responsibilities when a key role is vacated without advance notice. A purchase approver is a small version of that key role.

5. Approvals are buried in chat and email

A WhatsApp approval scrolls out of sight within hours, and an email approval sits in one person's inbox. Neither shows anyone else what is pending, and neither leaves a record a reviewer can easily inspect.

Seven fixes, and who does each one

  1. Name one approver for each step. Write down who approves which requests, by department and by type, and who comes next. Who: the owner or finance manager. For limits by amount and a one-page matrix, see who can approve what.
  2. Refuse incomplete requests at the door. A request without a reason, a cost estimate, a department and any quote it relies on goes back before it reaches an approver. Who: requesters, with procurement checking. The fields are listed in how to organise purchase requests.
  3. Set a response target for each step. For example, one working day for a routine request. The target is your policy, not a law; the value is that everyone knows when a request counts as late. Who: the owner or managing director, written into the purchasing policy.
  4. Name a backup for every approver. Agree who signs when the approver is on leave or travelling, and update the approval route before the absence, not after a week of waiting. Who: department heads, confirmed by the owner.
  5. Keep approvals in one place, reachable from a phone. One queue where every pending request is visible, which approvers can open away from their desk. Approvals given in chat do not count until they are recorded there. Who: the administrator who sets up the process, and every approver.
  6. Follow up on a schedule, not on feelings. When a step passes its target, the requester sends one reminder. If it is still stuck, the requester's manager calls the approver. Who: requesters first, then their manager.
  7. Ask for changes instead of parking the request. If something is missing, the approver sends it back with a specific question the same day, rather than leaving it pending or rejecting it outright. Who: approvers.

One caution for finance readers: speed must not cost control. Do not fix delays by letting requesters approve their own purchases. The Green Book describes segregation of duties, separating authority, custody and accounting, as a way to help prevent fraud, waste and abuse. A faster route through the right people is the goal, not fewer people.

How to measure before and after

You need a baseline to know whether the fixes worked; a month of records is enough for a small business.

  1. Take every purchase request from the last month (or the last 20, if you have fewer).
  2. For each one, note when it was submitted, when each approval step was completed and when the final decision came.
  3. Work out the waiting time per step. Then ask approvers roughly how long they spend on a typical request; that is your work time.
  4. Count how many requests were sent back for missing information.
  5. Repeat after six weeks of running the fixes and compare.
Measure How to work it out What it tells you
Time to decision Final decision time minus submission time The delay the requester feels
Waiting time per step Step completed minus step started Which approver or step is the bottleneck
Send-back rate Requests returned for missing details ÷ all requests Whether fix 2 is working
Requests past target Steps that took longer than your response target Whether fixes 3, 4 and 6 are working

Use the middle value (the median) rather than the average, so one request stuck for a month does not hide the improvement on the rest.

Diagnostic table: symptom, likely cause, fix

Symptom Likely cause Fix
Requests sit for days, then are approved in seconds Waiting, not work: nobody noticed or followed up Fixes 3, 5 and 6
Requests are forwarded between managers Unclear approver Fix 1
Approvers reply with questions instead of decisions Incomplete request Fixes 2 and 7
Everything stops when one person travels No backup approver Fix 4
Nobody can say where a request is Approvals in chat and email Fix 5
Staff buy first and seek approval later Process seen as too slow to bother with All of the above, then measure and share the results
One step is always the slowest Overloaded approver or a step that adds little Review whether that step is needed at that level (see fix 1)

How RequisitionPro helps

All seven fixes can run on a policy and a spreadsheet. The platform helps by making waiting visible and follow-up routine.

Difficulty: approvers do not know a request is waiting for them. Approval workflows are set up per department, with each step assigned to a person or a role, so every request goes to a named approver. When a requisition reaches a step, the approvers for that step get a notification, and the requester can see the status on the requisition at any time.

Difficulty: you cannot see where the time goes. The approval trail on each requisition shows every step, how long a completed step took and how long the current step has been pending. That is the waiting-time measure above without a stopwatch.

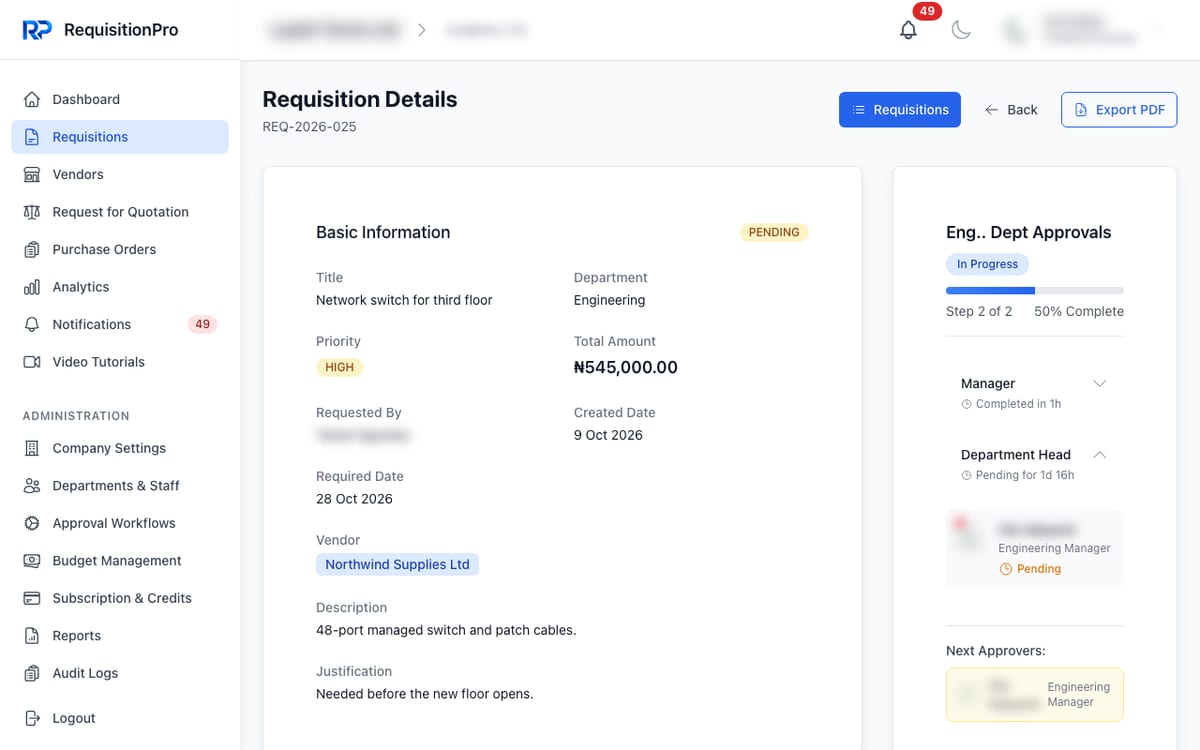

RequisitionPro requisition details for a pending ₦545,000 network switch request, with the engineering department's approval trail (Eng.. Dept Approvals) at step 2 of 2: Manager completed in 1h, Department Head pending for 1d 16h, and the next approver highlighted.

Difficulty: chasing feels awkward. While a requisition is pending, the requester sees a Send Reminder card and can send a reminder to the approver. Reminders are limited in number, so they prompt without becoming noise; if a request is still stuck after that, fix 6 (a manager's phone call) applies.

Difficulty: requests stall over a missing detail. An approver can choose Request Amendment, which needs a reason typed into the comment box. The requisition goes back to the requester, who is notified, edits it and resubmits it for approval. Approvers can add an optional comment when they approve; rejecting needs a reason.

Difficulty: approvers are away from their desk. RequisitionPro is a web app that works in a phone browser and has been optimised for phones, so an approver can open a requisition and approve it while travelling. There is no separate mobile app to install.

One boundary to be clear about: the platform does not hand a request to a backup approver automatically or escalate it on a timer. Fix 4 stays a policy decision: agree the backup and update the approval route before the absence.

How long should a purchase approval take? There is no universal standard. Set a target per step that fits the request type, write it into your policy and measure against it. If you have no data yet, pick a simple starting point, such as one working day per step for routine purchases, and adjust once you have a month of figures.

Should we approve on WhatsApp when it is urgent? Treat a chat message as a heads-up, not the approval. Record the decision in your approval system or register the same day, so the file shows who approved and when.

Does a faster process mean weaker control? Not if the same people still approve. Most of the time saved comes from cutting waiting, not from skipping checks.

Next step

Watch the "Approval Workflows" video (1:45) on the tutorials page to see how approval steps are set up and how a requisition moves through them.

Sources

These references are provided for general information and open in a new tab. Rules and practice differ by country and by organisation, so check the requirements that apply to you. This article is not legal, tax or financial advice.

  1. Cycle Time (Lexicon Terms), Lean Enterprise Institute (opens in a new tab) lean.org
  2. Standards for Internal Control in the Federal Government (Green Book), GAO-25-107721, US Government Accountability Office, May 2025 (opens in a new tab) gao.gov
  3. Procurement without timelines breeds waste – BPP, News Agency of Nigeria, 3 March 2026 (opens in a new tab) nannews.ng
